Skip to content

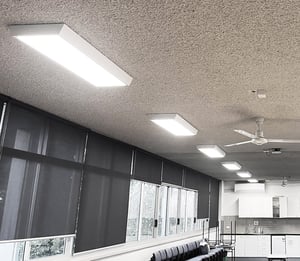

Schools lighting 4

PROJECT

School Infrastructure NSW

School LED Lighting Upgrade Program

CLIENT
School Infrastructure NSW
SITE
Nine operational public school sites across northern Sydney
DELIVERY
March – July 2026
SERVICE TYPE
LED lighting, ceiling fan and associated electrical upgrades

PROJECT OVERVIEW

Modernising essential electrical assets across nine public schools.

Platinum Electricians delivered a coordinated program to replace ageing fluorescent lighting with energy-efficient LED technology. Nominated ceiling fans, switches and controls were also upgraded to improve reliability and consistency across learning and support spaces.

The program was carefully planned around school activities and completed using after-hours, weekend and school holiday work windows.

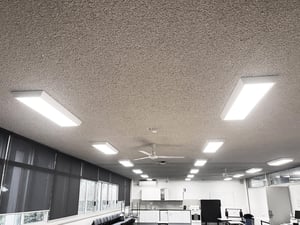

Schools lighting 4
$830,000 PROJECT VALUE
9 SCHOOL SITES
~$24,700 ANNUAL ENERGY SAVINGS
2,060 LIGHT FITTINGS UPGRADED

SCOPE OF WORKS

The program was delivered across three awarded work packages and nine operational school environments. Works were sequenced building-by-building and predominantly undertaken after school hours, on weekends and during school holiday windows.

  • Removal of existing fluorescent light fittings;
  • Installation of LED panels, battens, downlights and retrofit lamps;
  • Replacement of nominated ceiling fans and controllers;
  • Replacement of switches within upgraded rooms;
  • Electrical isolation, testing and commissioning;
  • Minor patching, painting and reinstatement;
  • Asbestos risk controls within nominated areas;
  • Compliance, quality and handover documentation.

Delivery Priority: Complete the upgrades safely and efficiently while maintaining secure, functional and low-disruption learning environments.

SAFETY AND SUSTAINABILITY

Controls designed for occupied school environments

All works were managed under Platinum Electricians' certified WHS Management System, tailored to live school environments and site-specific risks including student access, working at heights, electrical isolation and asbestos-containing materials.


WHS Management Plans, SWMS and task-specific JSAs;


Site inductions, daily pre-starts and toolbox talks;


Lock-out/tag-out procedures for electrical isolation;


Exclusion zones, fencing and safety signage;


Scaffolding and EWP access for elevated works;


Asbestos register review and hygienist oversight where required.



Lower-energy lighting and responsible material recovery

The upgrade replaced inefficient fluorescent lighting with modern LED technology, cutting energy use and maintenance demand while preparing the schools for the upcoming fluorescent lamp phase-out.

Low-Impact RetrofitsRetrofit solutions were selected where possible to avoid disturbing asbestos-containing ceilings and reduce unnecessary waste.
LED TransitionLower-energy lighting with improved
reliability and longer service life.
Specialist RecyclingRemoved fluorescent tubes were sent to Ecocycle for safe specialist processing
Segregated WasteSteel, mercury-containing lamps, general waste and contaminated materials were managed through separate streams

VERIFIED FROM INSTALLATION TO HANDOVER

Quality was controlled through documented Inspection and Test Plans, progressive checks and post-installation audits at each school. Completed works were inspected, tested and verified before practical completion and client sign-off.

1
Pre-Work Records
Site inspections, dilapidation surveys and photographic records established existing conditions.
2
Progressive Inspections
Installation quality was checked throughout delivery against the specified products and requirements.
3
Testing & Commissioning
Electrical compliance, functionality and correct operation of lighting, fans and controls were verified.
4
Post-Job Audits
Completed areas were quality inspected, with identified defects recorded and rectified before practical completion.
5
Client Sign-Off
Final walkthroughs were coordinated with SINSW and school representatives before handover.
6
Handover Records
Test results, compliance certificates, warranties, asset information and as-built documentation were submitted.

PROJECT OUTCOMES

A compliant, reliable lighting solution ready for long-term operation.

The completed upgrades improved lighting consistency and energy performance while reducing the maintenance burden associated with ageing fluorescent fittings. All nominated work areas were fully reinstated, documented and handed back for use. The project was successfully delivered to the required standards, with excellent feedback received from School Infrastructure NSW (SINSW) regarding the overall quality and delivery of the works.
